Access control and building security upgrade
Defined a practical access-control upgrade across doors, elevators, cameras, wiring, tenants, vendors, building operations, and landlord requirements.
Buildings & Spaces
Coordinated a fire alarm panel relocation out of secure tenant space while preserving life-safety access, tenant coordination, and related device upgrades.
With Pentillion Construction, I helped coordinate a fire alarm system retrofit in an occupied commercial building. The existing fire panel was outdated and located inside a secure tenant area, which created access and operational constraints for building management, contractors, and emergency-related service work.

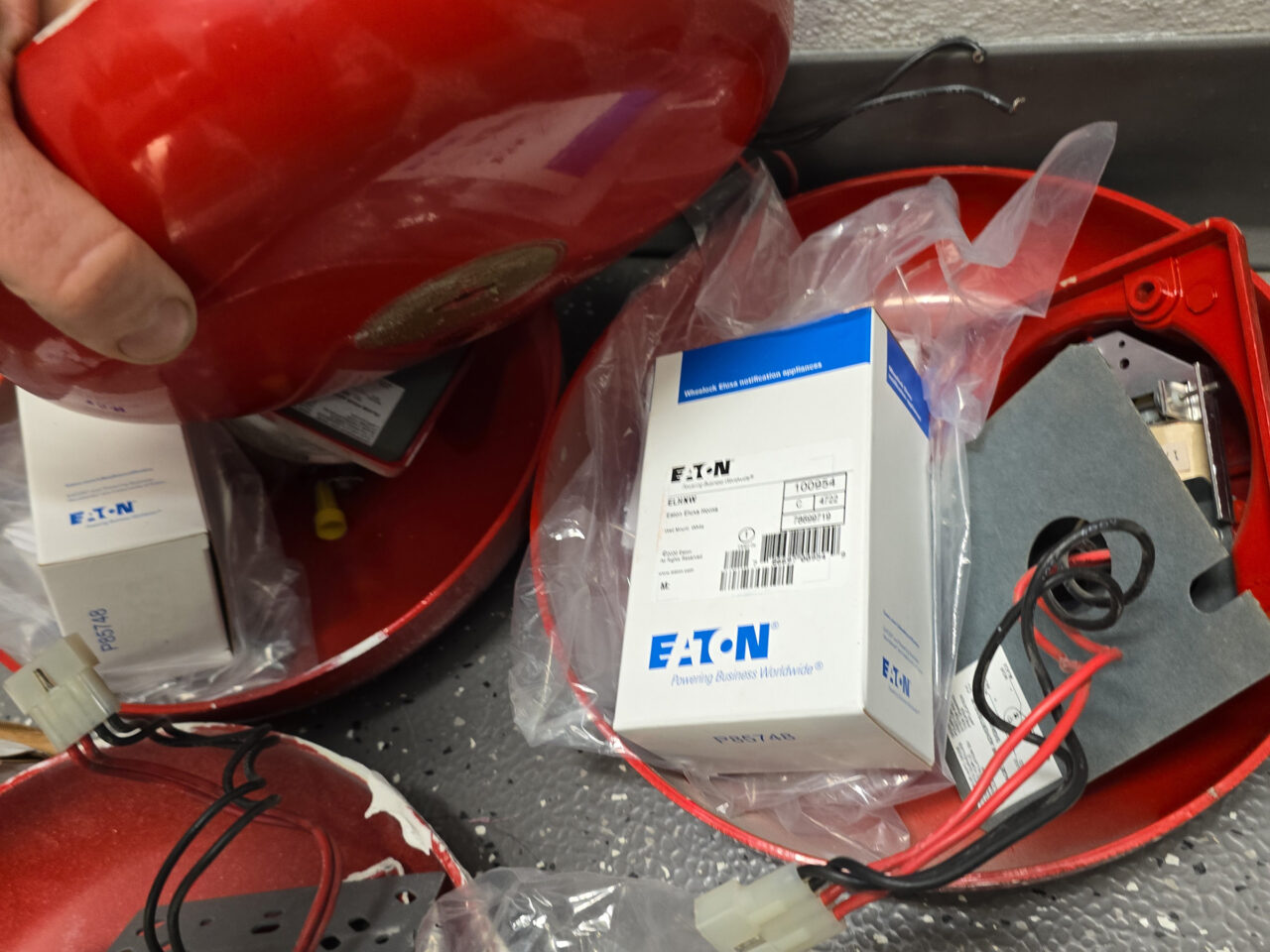

The project involved more than simply replacing equipment. The panel needed to be upgraded and relocated to a more appropriate building service area, while related alarm devices such as bells and pull stations also needed to be reviewed and upgraded as part of the broader retrofit.
I engaged multiple contractors to understand the available paths forward and help shape a practical scope. The work required coordination between the fire alarm contractor, security contractor, electrician, tenants, and building operations. Because the existing panel location was inside a secure space, access had to be planned carefully and coordinated with the affected tenant and other building users.
The crossover-floor requirements added another important layer. Because crossover floors form part of the building’s life-safety strategy, the access and fire alarm work had to be considered in that context rather than treated as a simple equipment swap. The retrofit needed to improve serviceability and bring the equipment into a better location while preserving the required life-safety function of the building.
The result was a more serviceable fire alarm system with the panel relocated out of the secure tenant space and related devices upgraded as part of the work. The project shows the coordination behind a relatively contained building-system upgrade: understanding the operational problem, checking the code-related constraints, aligning the right contractors, and completing the work without exposing tenants or building users to unnecessary disruption.
Related
A few related projects with the same kind of problem-solving thread.
Defined a practical access-control upgrade across doors, elevators, cameras, wiring, tenants, vendors, building operations, and landlord requirements.
Buildings & Spaces
With Pentillion Construction, I defined and coordinated an access-control upgrade for an 8-storey commercial building across doors, elevators, cameras, wiring routes, tenants, vendors, and landlord requirements. More than adding hardware, this project meant balancing security, usability, code-required access, cost, and day-to-day building operations.
The important work was defining what the system needed to do before deciding how much equipment to add. I clarified which access points needed control, how tenants and building staff would use the system, and how the work could be coordinated across the security contractor, electricians, elevator company, automated-door contractor, tenants, and landlord.
One key constraint was elevator access. The building needed more control over certain areas, but a full elevator-control upgrade would have added cost and complexity beyond the practical scope. I worked through a solution that controlled access where it mattered without turning the project into a larger elevator modernization.
The crossover floor added an important code-related check. Because that floor formed part of the building’s exiting and life-safety strategy, I could not treat every door as a simple security point. The access-control approach had to preserve the floor’s required function.
After installation, I managed the system and added practical event-based automations that reduced manual steps for building management. The result was a more usable security system because the operating requirements were defined before the technical solution was locked in.
Coordinated a landlord-side restaurant shell conversion through legacy electrical capacity, HVAC separation, underground plumbing, hazardous materials, code review, and field troubleshooting.
Buildings & Spaces
With Pentillion Construction, I represented the building owner through a complex restaurant tenant shell conversion in an existing commercial building. The work required aligning lease obligations, consultant drawings, tenant requirements, field conditions, trade scopes, code review, and legacy building systems while keeping the turnover moving.
Reverse engineered and documented an older HVAC control system so contractors could upgrade equipment while maintaining compatibility with existing building hardware.
Buildings & Spaces
With Pentillion Construction, I helped audit and explain an older HVAC control system so contractors could upgrade equipment while keeping parts of the existing system compatible. I also diagnosed a difficult air-handler vibration issue, where practical inspection pointed to a hidden duct condition before the project jumped to costly specialized testing.
